“A polar plunge: The Coast Guard bets on the burgeoning Arctic” –MyCG

Polar Star, Storis, and Healy. U.S. Coast Guard Cutter Healy (WAGB-20) arrives at Pier 46 on Coast Guard Base Seattle, Oct. 26, 2025. The crew of the Healy transited over 20,000 miles, supporting Operation Arctic West Summer and Operation Frontier Sentinel, protecting U.S. sovereign rights and territory, and promoting national security in the Arctic. (U.S. Coast Guard photo by Lieutenant Christopher Butters)

Below is a post from MyCG.

It is worth noting that our ally, Canada, is also building a new generation of icebreakers in cooperation with the Finns. In fact the Arctic Security Cutters will be built to two designs shared with Canada.

Canadian Coast Guard Multi-Purpose Icebreaker (MPI). Source: Seaspan
Note: The MPI image does not show the right propulsors; it will use Steerprop’s contra-rotating propulsors (CRP). Additionally according to Seaspan, the design could easily be upgraded to PC3. Confirmation from Seaspan and Aker Arctic.

Jan. 6, 2026

A polar plunge: The Coast Guard bets on the burgeoning Arctic

By Katie Duckett, The Circuit writer

Editor’s note: This article was originally published in The Circuit C5ISC blog. (CAC required)

After decades of watching its polar fleet degrade toward obsolescence, the Coast Guard is now poised for a historic transformation in the world’s coldest waters. The spending bill signed on July 4, 2025 has delivered nearly $9 billion for icebreaker construction to the Coast Guard, the single largest polar investment in service history, setting the stage for what officials are calling a new era of American presence in the Arctic and Antarctic.

The timing couldn’t be more fitting. For years America’s polar ambitions have rested largely on the shoulders of USCGC POLAR STAR (WAGB-10), an icebreaker commissioned in 1976. Now 49 years old and nearly two decades past her designed service life, she remains the only American ship capable of punching through the thick ice surrounding McMurdo Station in Antarctica, a mission she has performed faithfully for 28 consecutive years during Operation Deep Freeze.

Alongside POLAR STAR, USCGC HEALY (WAGB-20) has spent a quarter century conducting Arctic research and patrol, identifying underwater volcanoes and mapping the seafloor while monitoring the increasing presence of Russian and Chinese vessels in polar waters. But electrical fires and mechanical strain have tested this workhorse; in December 2024, USCGC STORIS (WMEC-38) became the first polar icebreaker added to the fleet in 25 years, offering immediate relief. Commissioned in Juneau last August, she completed a 112-day inaugural Arctic patrol that fall, shadowing five Chinese research vessels operating in American waters. The purchase served as a bridge strategy, buying time until heavier reinforcements would arrive.

Announced this May, the Coast Guard’s Force Design 2028 initiative has designated polar capability a cornerstone of service transformation. FD28 explicitly calls for delivering “icebreakers needed to provide assured U.S. access and presence to the polar regions” while streamlining acquisitions to accelerate timelines that have historically lagged.

The Coast Guard’s vision for polar operations is now bankrolled at historic scale. This year’s spending bill allocates $4.3 billion for three Polar Security Cutters, massive 460-foot heavy icebreakers capable of smashing through ice 21 feet thick. The first of these, USCGC POLAR SENTINEL (WMSP-21), is expected to enter service around 2030. Another $3.5 billion will fund the Arctic Security Cutter program, which received a dramatic boost in October 2025 when the President signed an agreement with Finland to deliver 11 medium icebreakers, with the first five set to arrive by 2028. When combined with the additional light icebreaker funding included in the bill, the legislation enables construction of 17 new vessels in total, a number that would have seemed unthinkable just five years ago.

The urgency of Arctic operations extends beyond aging hulls. Russia currently operates more than 40 icebreakers, continuing to militarize its Arctic coastline. China, despite possessing no Arctic territory, has declared itself a “near-Arctic state” and deployed its own coast guard vessels alongside Russian patrols near Alaska. And a changing climate is unlocking shipping lanes and resources that will demand American presence and enforcement.

After decades of deferred maintenance and delayed procurement, the Coast Guard’s polar plans are finally scaled to the challenge. This frozen frontier, once patrolled by a single aging ship, will soon host a fleet befitting American strategic interests at both poles.

Contract for “Polar Security Cutter land based test facility and production integration facility long lead time material”

DOD “Contracts For Dec. 18, 2025” included this for the Polar Security Cutter program.

Bollinger Mississippi Shipbuilding (BMS), Pascagoula, Mississippi, is awarded a $33,077,880 cost reimbursable contract modification to previously awarded contract (N00024-19-C-2210) for Polar Security Cutter land based test facility and production integration facility long lead time material. Work will be performed in Pascagoula, Mississippi, and is expected to be completed by September 2027. Fiscal year 2025 procurement, construction, and improvement (Coast Guard) funds in the amount of $16,505,862 will be obligated at time of award and will not expire at the end of the current fiscal year. Naval Sea Systems Command, Washington, D.C., is the contracting activity.

Thanks to Paul for bringing this to my attention.

“U.S. Coast Guard authenticates keel for offshore patrol cutter Pickering” –News Release

USCGC Pickering Artist rendering starboard quarter. Credit: Austal

Below is a Coast Guard news release. Good to see progress on the Austal portion of the OPC program.

Dec. 9, 2025

U.S. Coast Guard authenticates keel for offshore patrol cutter Pickering

WASHINGTON — The Coast Guard authenticated the keel for the future Coast Guard Cutter Pickering during a ceremony Monday in Mobile, Alabama.

Keel authentication is a time-honored shipbuilding tradition marking the formal start of a vessel’s construction. During the ceremony, the sponsor’s initials are applied to a ceremonial keel plate that will be installed on the cutter, symbolically indicating the keel is “truly and fairly laid.”

Adm. Kevin Lunday, acting commandant of the Coast Guard, attended the event along with Rep. Mike Ezell of Mississippi, chairman of the House Transportation and Infrastructure Subcommittee on Coast Guard and Maritime Transportation; Michelle Kruger, president of Austal USA; and more than 100 guests.

“This event highlights the progress made towards delivering this much-needed asset to the nation,” said Rear Adm. Chad Jacoby, deputy commandant for systems and chief acquisition executive. “With OPC design and modeling activities fully complete and production underway, we are gaining speed towards recapitalization of our medium endurance fleet.”

Ravi Khamsourin, an advanced welder with Austal USA, placed the initials of the sponsor, Dr. Meghan Pickering Seymour, on the ceremonial keel plate. Pickering Seymour is Pickering’s great-great-great-great-great-granddaughter.

Pickering is named after a revenue cutter built in 1798 that bore the same name. The vessel was named in honor of Timothy Pickering, the second secretary of war. Pickering fought in the American Revolution as a colonel and served as adjutant general of Gen. George Washington’s army in 1777. He later served as secretary of state, a U.S. senator and a member of the House of Representatives from Massachusetts. He advocated for construction of the first frigates built to enforce tariff and trade laws and prevent smuggling.

Pickering will be the third Coast Guard vessel to carry the name. In addition to the original revenue cutter Pickering, the Coast Guard operated a concrete-hull floating base bearing the name Pickering during the 1920s.

The OPC acquisition program addresses the Coast Guard’s long-term need for cutters capable of deploying independently or as part of task groups. The cutters provide essential capability for the Coast Guard to control, secure and defend U.S. borders and maritime approaches, facilitate maritime commerce vital to economic security and strategic mobility, and respond to contingencies. Acquisition of 25 OPCs will complement the service’s national security cutters, fast response cutters and polar security cutters as part of the Department of Homeland Security’s layered security strategy.

Delivery of Pickering is scheduled for 2027.

Some Background on the OPC Program and the Cutter X Alternative

Below is my input to a discussion among my classmates. It is mostly history, but hopefully useful. As I was preparing this, I was struck by the realization that when the Crew Rotation Concept was thrown out, it should have resulted in a complete revision of our program of record.

When the program of record began, it was to replace 12 WHECs, 32 WMECs, and 49 WPBs, a total of 93 vessels with 8 NSCs, 25 OPCs, and 58 FRCs, a total of 91 vessels.

This plan also assumed the NSCs and OPC would use the Crew Rotation Concept that would have theoretically provided about a third more underway days than conventionally crewed cutters.

The Crew Rotation Concept was ultimately discarded, taking with it about 1980 underway ship days or eleven ship years.

This was partially offset by adding NSCs #9 and #10, but we are still getting the equivalent of nine large patrol cutters less than originally planned.
Coast Guard missions seem to be expanding. This has been partially addressed by building more FRCs than originally planned. The FRCs have exceeded our expectations and we are planning to have 77 of them, but we are still looking at only 35 large patrol cutters, 10 NSCs and 25 OPCs. I don’t think that is enough.
The Coast Guard has been describing the OPCs this way, The OPC will provide a capability bridge between the national security cutter, which patrols the open ocean in the most demanding maritime environments, and the fast response cutter, which serves closer to shore.”

That is not really true. The OPC and the NSC are virtually the same size. The OPC may be intended to replace the MECs, but in fact it is 1250 tons larger than the Hamilton class WHECs and 2.5 times the size of a WMEC270. The OPC will also have a crew almost the size of that of the NSC. With a range of over 10,000 nautical miles they are high endurance cutters.

In 2012 the OPCs were expected to cost about half of what an NSC cost, now the costs to build and operate are approaching that of an NSC.
Since 2012 I have been suggesting that we could meet the need for more large cutters by building a true medium endurance cutter by basically putting the crew and equipment of a FRC in a large hull (at least 80 meters/262 feet) and trading off some OPCs and FRCs for these medium size ships. https://chuckhillscgblog.net/2012/10/12/the-dhs-cutter-study-trade-offs-and-the-case-for-cutter-x/
Two years later I did a revised look. https://chuckhillscgblog.net/2014/09/28/cutter-x-revisited/ and along the way, I pointed out several ships that could fill the Cutter X role. Actually they just seem to be the typical Offshore Patrol Vessel.
The Japanese are building a class that reflects the Cutter X ideas, a relatively large ship, 312 feet in length, about half the displacement of the OPCs, with a crew of only 30. https://chuckhillscgblog.net/2025/11/14/offshore-patrol-vessels-for-the-japanese-maritime-self-defense-force-launched/
Since the geopolitical situation has changed and war with China looks more likely I have begun to think we should start building cutters that are more immediately useful in the event of war.
Congress has been telling the Navy they need to look at building Corvettes to bulk up their numbers and the next Navy league magazine is supposed to have a story about the proposal. Assuming these are ASW capable corvettes, this might be a class that could be built as a dual service ship, serving in both the Navy and Coast Guard.

Offshore Patrol Vessels for the Japanese Maritime Self Defense Force Launched

The first and second ships of the Japan Maritime Self-Defense Force’s new patrol vessel class, Sakura and Tachibana, were launched by Japan Marine United (JMU) on November 13, 2025 (photo by Kosuke Takahashi).

Naval News reports the launch of the first two of twelve Offshore Patrol Vessels (OPV) for the Japanese Navy.

“The new patrol vessels measure 95 meters (312 ft) in length, with a standard displacement of 1,900 tons (about 2300 tons full load–Chuck), a depth of 7.7 meters, a draft of 4.2 meters, and a top speed of 25 knots (28.8 mph)…automation technologies have been implemented to reduce crew requirements, limiting the necessary personnel to just 30.”

These ships are particularly interesting because they will operate a relatively large ship with a small crew.

This low crew count is achieved through high levels of automation, including systems like the “Automatic Berthing and Unberthing Function” and an “Integrated Monitoring and Control System” that allows for remote firefighting.

To keep costs down, the ships are relatively simple but include Combined Diesel-eLectric And Diesel (CODLAD) propulsion. The design incorporates space for containerized mission modules below the flight deck.

We have been following this program since its inception.

Over the course of its development, the gun has gotten smaller; the length seems to have been reduced from 100 meters to 95; and the boat and unmanned systems handling facilities have been enclosed as the flight deck was extended to the stern.

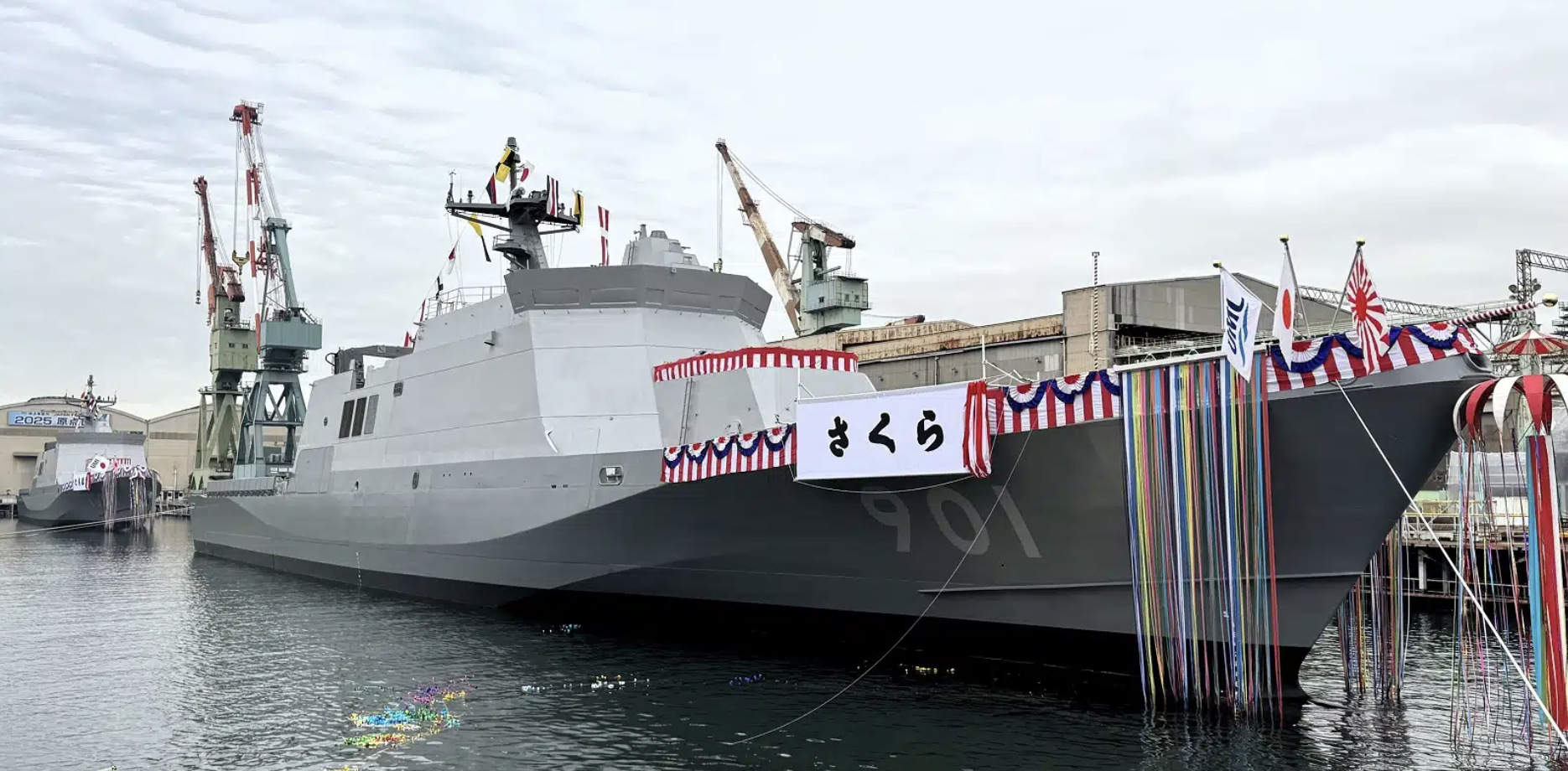

Sakura class OPV Japanese Maritime Self Defense Force, at launch. (photo by Kosuke Takahashi).

Two features I was not aware of is that they will use the V-Bat UAS, also used by the USCG and a Mine Counter Measures role has been proposed.

Construction has been very rapid. These two ships were laid down on February 14, 2025. The first four ships are expected to be delivered in 2027.

These will be the first OPVs in Japanese Navy. It is not unusual for navies to include OPVs if they do not have a sea-going Coast Guard, as is the case with the UK, France, and the Netherlands, but Japan has one of the largest Coast Guards in the world, with more large patrol cutters than the USCG. India also has a large Coast Guard and operates OPVs in both its Navy and Coast Guard.

“Building a ‘Heavy’ Icebreaker in Helsinki” –Sixty Degrees North

Sixty Degrees North intends to follow the construction of Canada’s heavy icebreaker in Finland,

“I intend to closely follow and document construction of the Polar Class 2 ‘heavy’ Polar Icebreaker at Helsinki Shipyard in my continuing effort to correct the false belief that Finnish companies cannot build the types of icebreakers needed by the U.S. Coast Guard…

“You will also see me reporting on Rauma Marine Construction’s (RMC) progress building the Finnish Navy Corvettes...At the moment, they have three (of a planned four) Corvettes in simultaneous production.”

The corvette is also interesting combining significant anti-air, anti-surface, and anti-submarine capability with a hull designed to operate in ice, all in a hull 15% smaller than that of an OPC. I look forward to hearing more about it.

The first multi-purpose corvette built for the Finnish Navy’s Squadron 2020 project was launched at Rauma shipyard on Wednesday 21 May 2025.

“Coast Guard Exercises Contract Option for 10 Additional Fast Response Cutters” –News Release

220822-A-KS490-1178 STRAIT OF HORMUZ (Aug. 22, 2022) From the left, U.S. Coast Guard fast response cutters USCGC Glen Harris (WPC 1144), USCGC John Scheuerman (WPC 1146), USCGC Emlen Tunnell (WPC 1145) and USCGC Clarence Sutphin Jr. (WPC 1147) transit the Strait of Hormuz, Aug. 22. The cutters are deployed to the U.S. 5th Fleet area of operations to help ensure maritime security and stability in the Middle East region. (U.S. Army photo by Spc. Noah Martin)

Below is a Coast Guard News Release.

Sept. 10, 2025

Coast Guard Exercises Contract Option for 10 Additional Fast Response Cutters

WASHINGTON — The U.S. Coast Guard has exercised a contract option with Bollinger Shipyards of Lockport, Louisiana, to fund initial construction on 10 additional Fast Response Cutters (FRCs), Tuesday. The $507 million option supports ongoing efforts to modernize the fleet and expand the Coast Guard’s global maritime mission.

The action made possible by the passage of Public Law 119-21, known as the One Big Beautiful Bill Act, increases the total number of FRCs ordered under the current agreement from 67 to 77. Supported by historic investments, this legislation provides nearly $25 billion – the largest single funding commitment in Coast Guard history – including $1 billion dollars for additional FRCs. The first FRC funded through this option is expected to be delivered in fiscal year 2028.

“As the first Coast Guard contracting action to execute over $100 million in reconciliation funds and the first reconciliation-funded action executed by a cutter program, this is a historic accomplishment for the Service,” said Rear Adm. Mike Campbell, the Coast Guard’s Director of Systems Integration and Chief Acquisition Officer. “Since its introduction to the fleet in 2012 as the successor to the 110-foot Island class patrol boat, the Fast Response Cutter has consistently proven its capabilities, adaptability and effectiveness in a wide range of maritime environments and Coast Guard missions.”

Sentinel-class FRCs are critical assets in the Coast Guard’s mission to control, secure and defend the U.S. border and maritime approaches. To date, 59 of these cutters are in service, replacing the aging fleet of 1980s-era Island-class 110-foot patrol boats. The Sentinel-class FRCs feature advanced command, control, communications, computers, intelligence, surveillance and reconnaissance equipment; over-the-horizon cutter boat deployment to reach vessels of interest; and improved habitability and seakeeping. Expanding the FRC fleet continues the Coast Guard’s modernization through Force Design 2028, an initiative introduced by Secretary of Homeland Security Kristi Noem to transform the Coast Guard into a more agile, capable and responsive fighting force.

The FRC fleet will complement the capabilities of the service’s national security cutters (NSCs), offshore patrol cutters (OPCs) and polar security cutters (PSCs) as an essential element of the Nation’s layered maritime security strategy.

“Helsinki Shipyard Begins Construction of Canadian Polar Icebreaker” –60 Degrees North

Canada’s Polar Max. I had the opportunity to attend the steel-cutting ceremony. Photo: Peter Rybski

60 Degrees North reports,

From an August 20th Davie press release:

In a historic milestone for the Canadian shipbuilding industry, Davie today officially began construction of the Polar Max icebreaker, a vessel that, once delivered by 2030, will redefine Canada’s Arctic capabilities.

Uniquely, Polar Max will be constructed through an innovative industrial collaboration between Canadian-controlled facilities in Helsinki, Finland and Lévis, Canada. Construction on the Polar Max hull will begin at Davie’s Helsinki Shipyard, which has built 100% of the complex medium to heavy icebreakers delivered from Finland over the past 25 years.

“The ICE Pact: One Year Later” –Sixty Degrees North

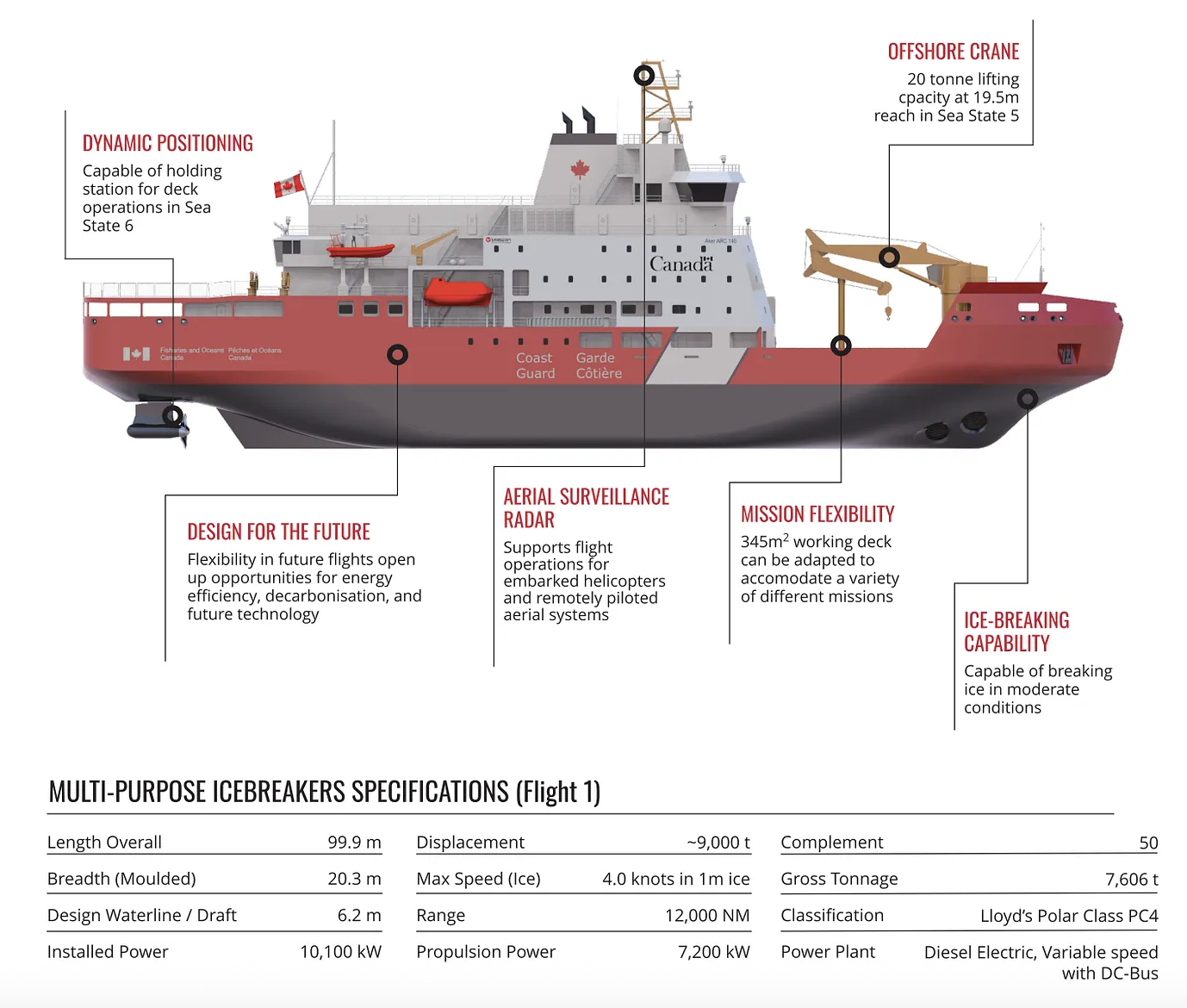

Canadian Coast Guard Multi-Purpose Icebreaker (MPI). Source: Seaspan
Note: The MPI image does not show the right propulsors; it will use Steerprop’s contra-rotating propulsors (CRP). Additionally according to Seaspan, the design could easily be upgraded to PC3. Confirmation from Seaspan and Aker Arctic.

To get a realistic view of the potential of the ICE Pact, I recommend a review of the Sixty Degrees North’s review of the state of the agreement after the first year–useful, but perhaps less than we might have hoped.

“Coast Guard announces agreement to construct new polar security cutter shipyard facilities” –CG-9

I am trying to catch up on things, but while this is an August 4 release from the Acquisitions Directorate, I think it is an important step in integrating the PSC’s machinery and providing training.

Coast Guard announces agreement to construct new polar security cutter shipyard facilities

As part of continuing efforts to foster growth within the domestic shipbuilding industry and maintain momentum for acquisition priorities, the Coast Guard on July 23 formalized an agreement with Bollinger Mississippi Shipbuilding (BMS) to construct a production integration facility and land-based test facility at the shipyard in Pascagoula, Mississippi, in support of the Polar Security Cutter (PSC) Program.

This action represents a significant step in the Coast Guard’s continuing investment in the domestic shipbuilding sector and collaboration with industry partners to deliver critical assets to the nation. The construction of both facilities represents a significant capital investment partnership between the Coast Guard and BMS that will support streamlined production and integration of PSC mechanical and communication systems for a simplified installation process.

The Coast Guard modified the construction contract for the first PSC, originally awarded on March 25, 2025, to provide funding for the integration and test facilities via capital expenditure incentives. These incentives benefit the shipyard by providing access to funding for facility upgrades, workforce training and wage increases.

For more information: Polar Security Cutter Program page
